FLOOD PROTECTION

Kawatiri Coastal Trail - Carter's Beach Westport

Flood Protection centres on building floodwalls and stopbanks with the aim of protecting Westport in the event of significant future flooding events.

The scheme is divided into five main stopbanks:

Lower Orowaiti, Upper Orowaiti, North End, Lower Buller (Wharf to Buller Bridge) and Upper Buller (SH67 from Buller Bridge to Nine Mile Road).

Within that, there are approximately 20 sub-sections of flood protection including smaller banks like Cats Creek, McKennas, portable barriers, and the Floating Lagoon stopbank.

This is the largest project being undertaken by Resilient Westport and is being led by West Coast Regional Council (WCRC).

The overall aim is to deliver structural mitigation works to prevent direct threats from both the Buller and Orowaiti rivers. These are caused by flooding generated upstream in the Buller catchment and from coastal inundation, particularly via the Orowaiti Lagoon.

The project is funded via a contribution of $15.6m from central government, along with a local share of $10.2 million. Additional funding is now required and WCRC is planning to consult with the community over the shortfall.

The current plan involves a combination of earth stopbanks, ‘planter-box’ stopbanks, concrete floodwalls, wooden floodwalls, and portable flood barriers. The total length will be around 16km.

In 2026, a review of the Westport Flood Protection Scheme (WFPS) has been carried out, after it became clear that there were affordabilty issues.

You can read more on this below.

Project Review

Westport Flood Protection Scheme reset

The development of the Westport Flood Protection Scheme (WFPS) is at the point where changes are required to deliver it in a more affordable way.

This means considering:

  • The impact on rates arising from the increased cost of the scheme

  • Changes to the level of flood protection to be delivered for Westport

  • Funding flood protection for Carters Beach.

The costs of the original scheme are now predicted to reach about $70 million, so the project team has worked on ways to reduce that and still deliver a more credible scheme.

One tool for doing so is to lower the level of protection to Westport to protect against an approximately 1 in 67-year flood (similar to July 2021) – as opposed to 1 in 100-year previously proposed. The level of freeboard (extra height allowance for uncertainty) would also be reduced from 600mm to 400mm following enhanced computer modelling.

The project reset has financial implications for ratepayers and represents additional debt for WCRC. These proposed changes represent a significant variation from what is included in the West Coast Regional Council’s current Long-Term Plan (2024-2034) and what was consulted on with the community in 2021. Therefore, additional consultation is required using a Special Consultative Procedure.

You can read more on this on our dedicated Special Consultative Procedure web page.

We frequently hear certain questions about the scheme and hope these FAQs can shed some light:

When did the project team get started?

The Resilient Westport Flood Protection Scheme has effectively been operating for around 2 and a half years (since early 2024).

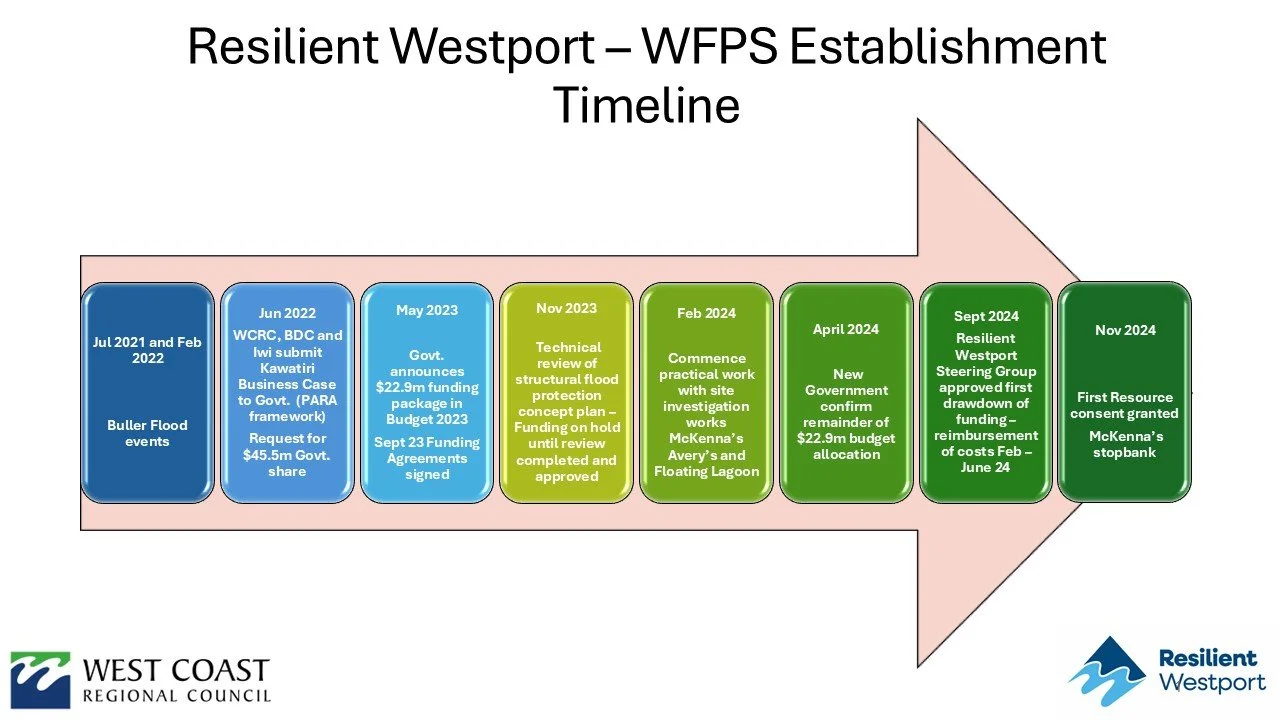

What was the project establishment timeline?

After the floods of 2021 and 2022, a business case was put to government to co-fund flood resilience for Westport.

In May 2023, government announced a $22.9 million funding package (Resilient Westport). In September 2023, the Department of Internal Affairs approved the $15.6 million funding for flood protection.

A technical review of the structural concept for the scheme was carried out between November 2023 and February 2024.

After this, real work began on scoping out the flood protection project.

You can also read more FAQs on the project.

See the timeline below for more:

Planned overall construction programme

The map below identifies the components of the substantive flood protection programme.

Note, the lines shown are indicative only. Where planned stopbanks cross, or are near to, private or public land, property owners will be contacted directly. We do this when we are carrying out investigative work and again as we get closer to final design and consent applications.

You can also download a pdf of this map here.

What consents are still pending?

O’Conor Home rockwall

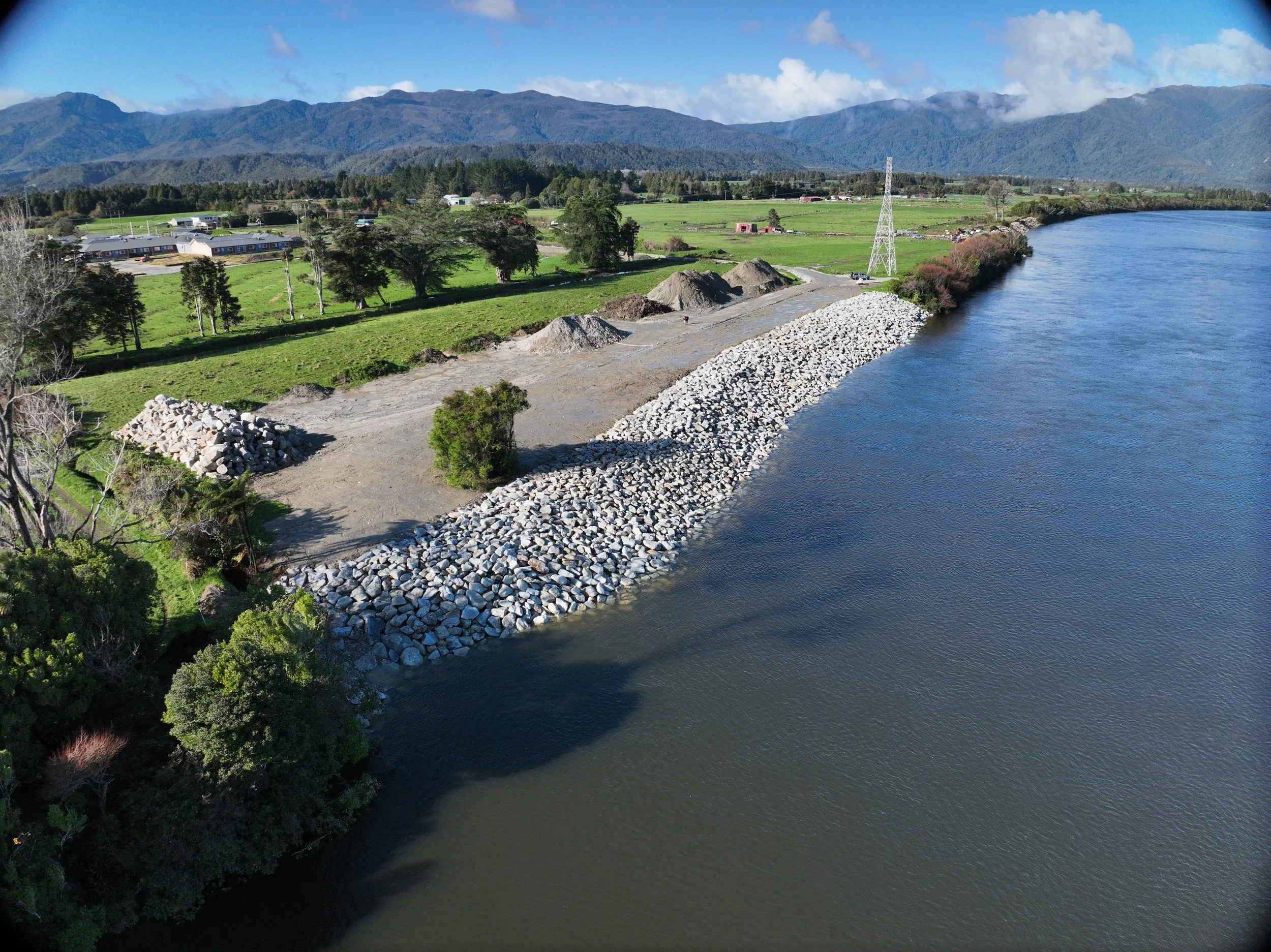

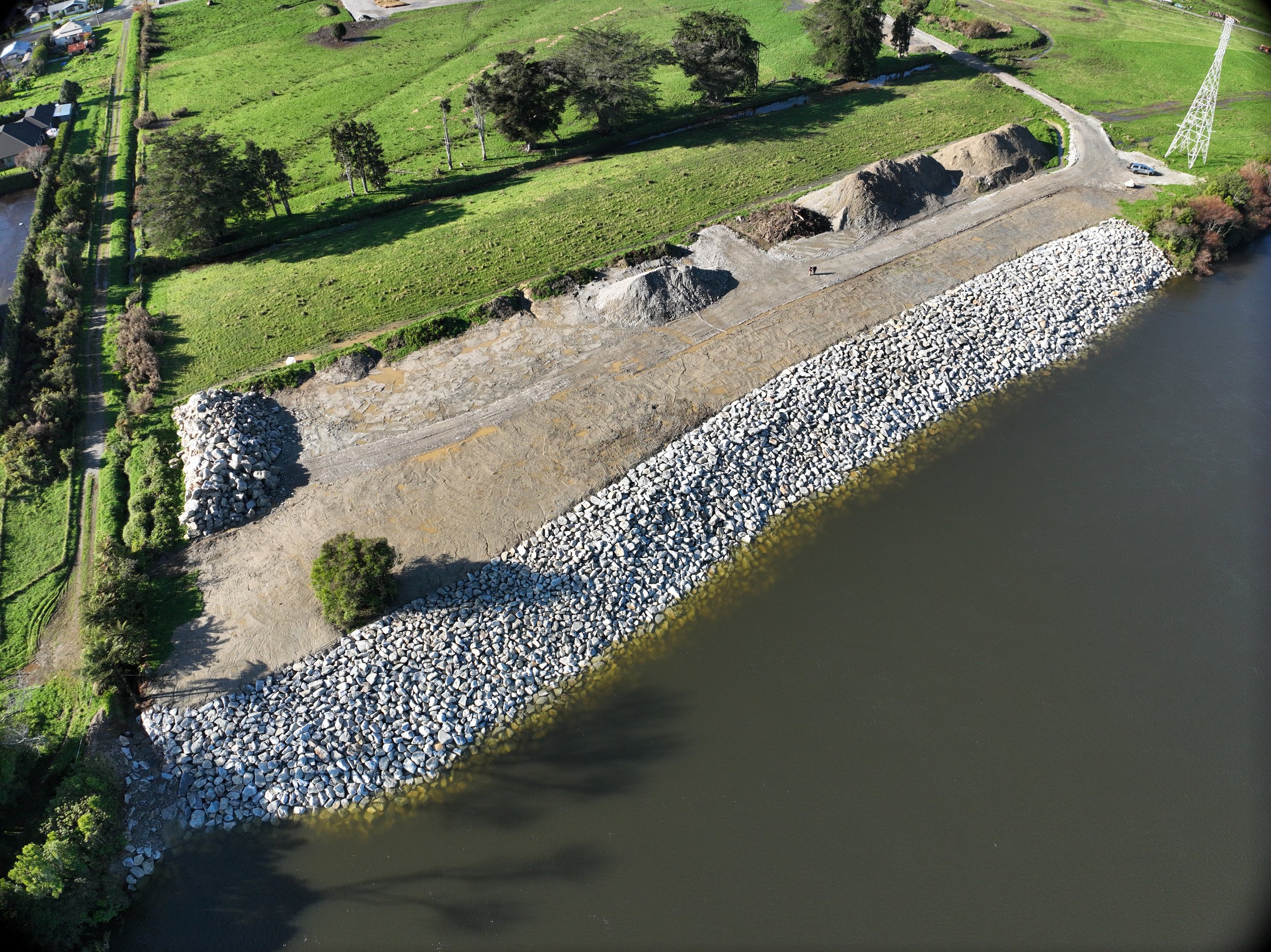

Work on the O’Conor Home rockwall is now complete.

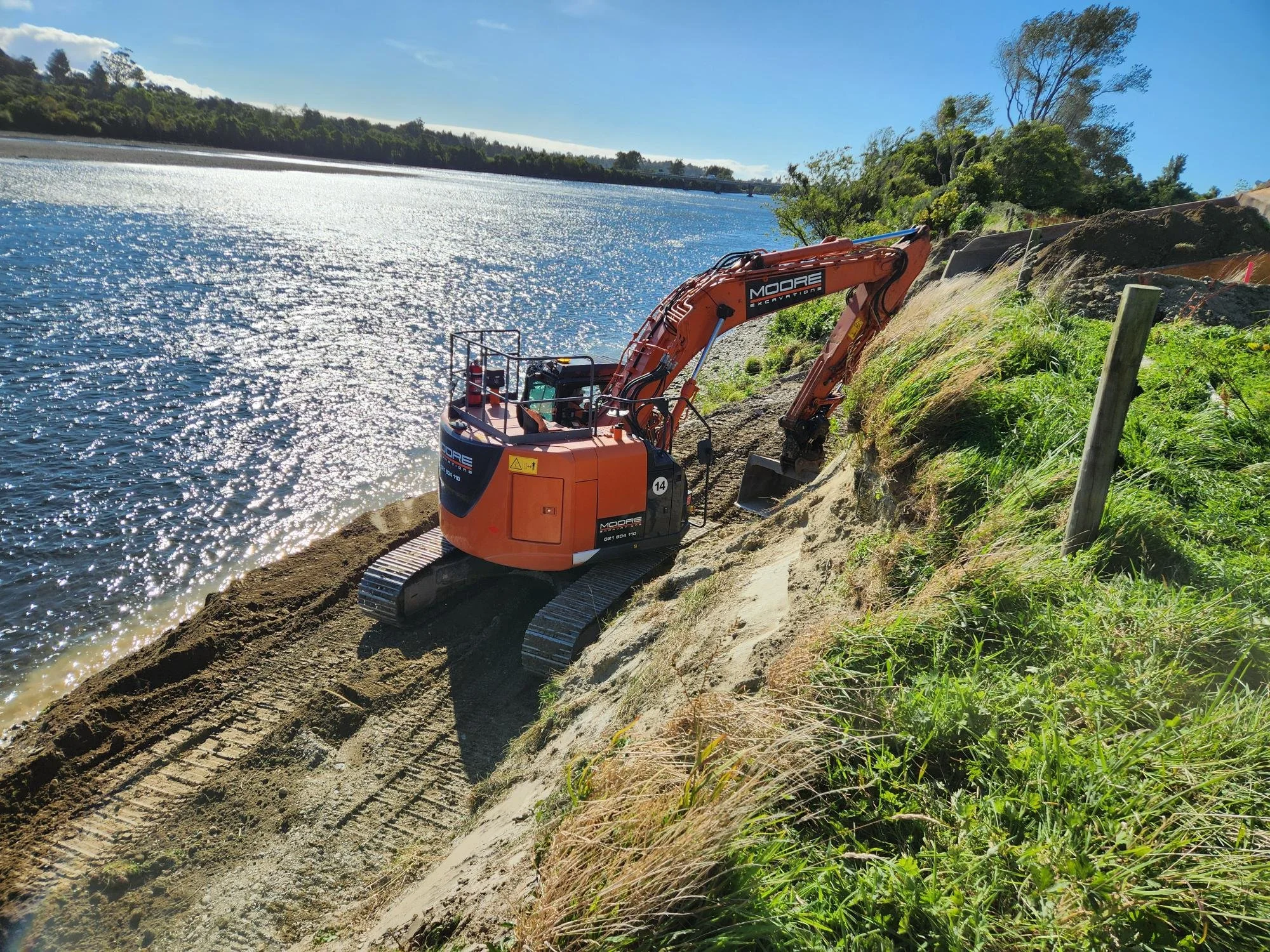

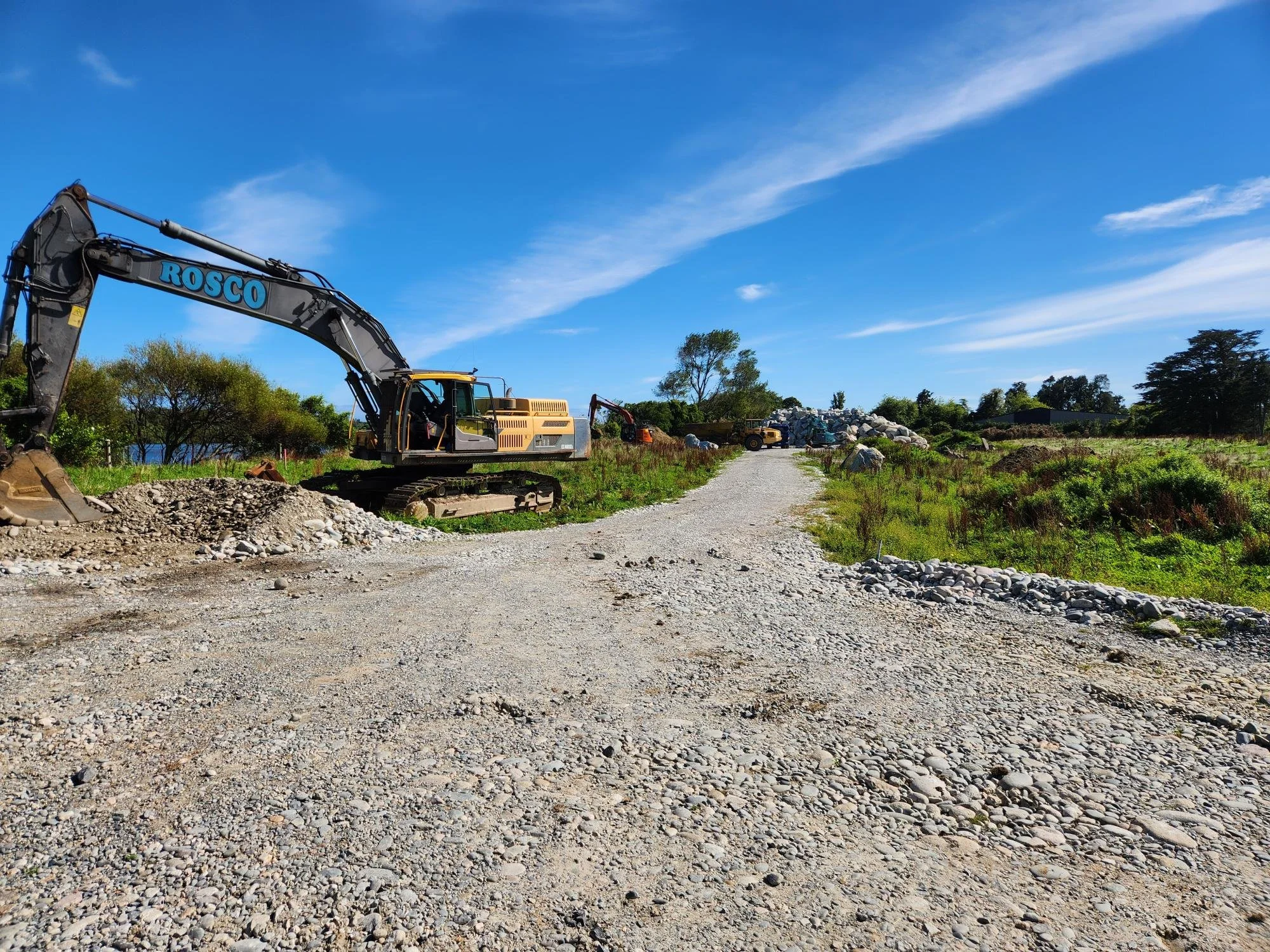

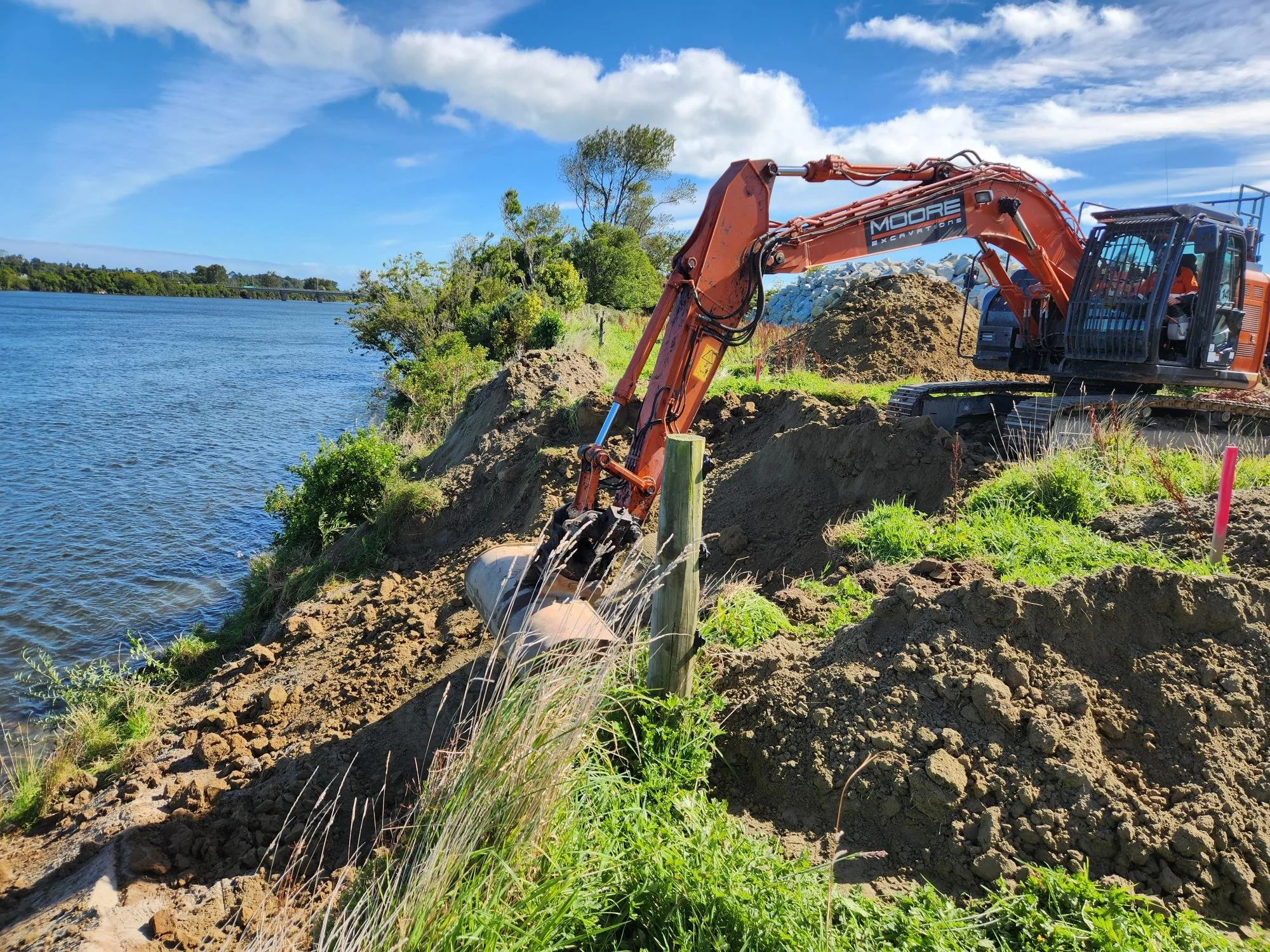

The 170-metre-long rock revetment wall along the Buller River near the O'Conor Home has been built as part of the wider Westport Flood Protection Scheme project.

The rockwall will provide greater security and resilience for the Upper Buller stopbank that is proposed for construction, a short distance inland.

Work began in March, wrapping up this month, in June 2026.

Around 20,000 tonnes of rock have been laid as part of the construction process.

There is some leftover rock that will remain as a stockpile for any future works.

Stage One Projects

The Stage One projects include stopbanks at:

  • Floating Lagoon (vegetation clearance complete)

  • Avery’s (consents granted)

  • Cats Creek (complete)

  • McKennas (complete)

The Floating Lagoon is a length of land near Westport where a stopbank and 200-metre-long portable flood barriers are planned. It is part of the North end stopbank. Vegetation clearance to allow remediation of the existing stopbank at Floating Lagoon is complete. A Resource Consent application was lodged on Friday (13 March 2026) with West Coast Regional Council (WCRC) and Buller District Council (BDC) for the Floating Lagoon stopbank.

A stopbank on the Avery’s stretch of the Orowaiti River is part of the Lower Orowaiti stopbank. Resource Consent has been granted and a construction date is to be announced.

The Cats Creek bund will redirect floodwaters to the Abattoir Drain. It was completed in late 2024. The bund will assist in reducing inundation of properties downstream of Cats Creek. Following the completion of geotechnical and planning work, physical work was carried out in September/October 2024. The remaining 10 metres, where the bund met with Kiwirail infrastructre was completed in 2026.

The McKenna stopbank is part of the Upper Orowaiti stopbank and is largely complete A small amount of finishing work is required at the ‘toes’ of the stopbank. A blessing ceremony was held on 18 December 2024 to mark the start of work. A Fact Sheet on the McKenna Stopbank provides information on the work. McKenna is the first of the larger stopbanks to be completed.

West Coast Regional Council Chair (at the time) Peter Haddock, along with Buller Councillor Mark McIntyre (WCRC), and Jo Dooley, on behalf of her late husband Frank Dooley, do the honours celebrating the start of work on McKenna Stopbank.

Organs Island

Orowaiti Overflow/Organs Island is the Buller River’s first overflow location. In the July 2021 flooding event, it overflowed into the Orowaiti Estuary and from there into parts of Westport.

The Orowaiti overflow is the original path of the Buller River and is where it naturally wants to go. It is called the ‘relic river channel’ and is the natural fall of the land.

This land has been vested with West Coast Regional Council for the purpose of flood protection. It was previously administered by Land Information NZ (LINZ) and leased for grazing. It was then transferred from LINZ to Department of Conservation (DOC). DOC then vested Organs Island as a local purpose (flood protection) reserve for West Coast Regional Council to manage as an administering body.

At the 16 December 2025 Operations Committee Meeting, Council approved accepting the vesting to itself (WCRC) as an administrative body.

WCRC has now taken over the management of the land (as at February 2026).

A flood protection options report is being prepared to understand the requirements and costs.  Council will then consider the plan for Organs Island.

A rock-training wall was rebuilt by WCRC at Organs Island after the floods and one option is further reinforcing it in some way. The option of revegetating Organs Island may fall to the WCRC at some point in the future, as this is not government funded.

Background

When it was originally diverted in the early 1890s the engineer wrote detailed notes that Organs Island area should be heavily vegetated. He suggested using blackberries and willows because they have strong root density and grow into dense vegetation. Vegetation traps water and sediment/silt and slows flood water. Over time, the land rises and self-seeding occurs. This is a clever, natural flood mitigation technique.

However, the land was gradually cleared and used for farming, weakening the original intent for Organs Island to work as a natural flood mitigant.

Modelling suggests revegetation would reduce water flowing down to the Orowaiti estuary by 10% in a large flood. It will also require less maintenance overtime, reducing costs for West Coast Regional Council.

Your Questions Answered
